For buyers

MIG or TIG? A buyer's guide to welded parts, welding codes and certified welders

What buyers need to know before ordering welded parts: MIG, TIG, stick, flux-cored, laser and robotic welding compared, why 85% of welding cost is labor and overhead, how weld size drives price, which code applies (AWS D1.1, D1.2, D1.3, D1.6, D17.1, ASME Section IX), what a certified welder and a CWI really are, and how to put it on the drawing.

By the EveryJobShop team · October 29, 2026 · 7 min read

A welded part often arrives with a drawing that says "weld all around" and a purchase order that says "certified welders". Both sound precise. Neither tells the shop which process, which weld size, which code or which inspection you expect, and those four decide most of the price.

So what should a buyer know before ordering welded parts?

Welding cost is mostly time, and time follows the process, the size and length of the welds, and the inspection you ask for. Codes and certifications decide who may weld and how the work is checked. This guide covers both, with the questions to ask a shop and what to put on the drawing.

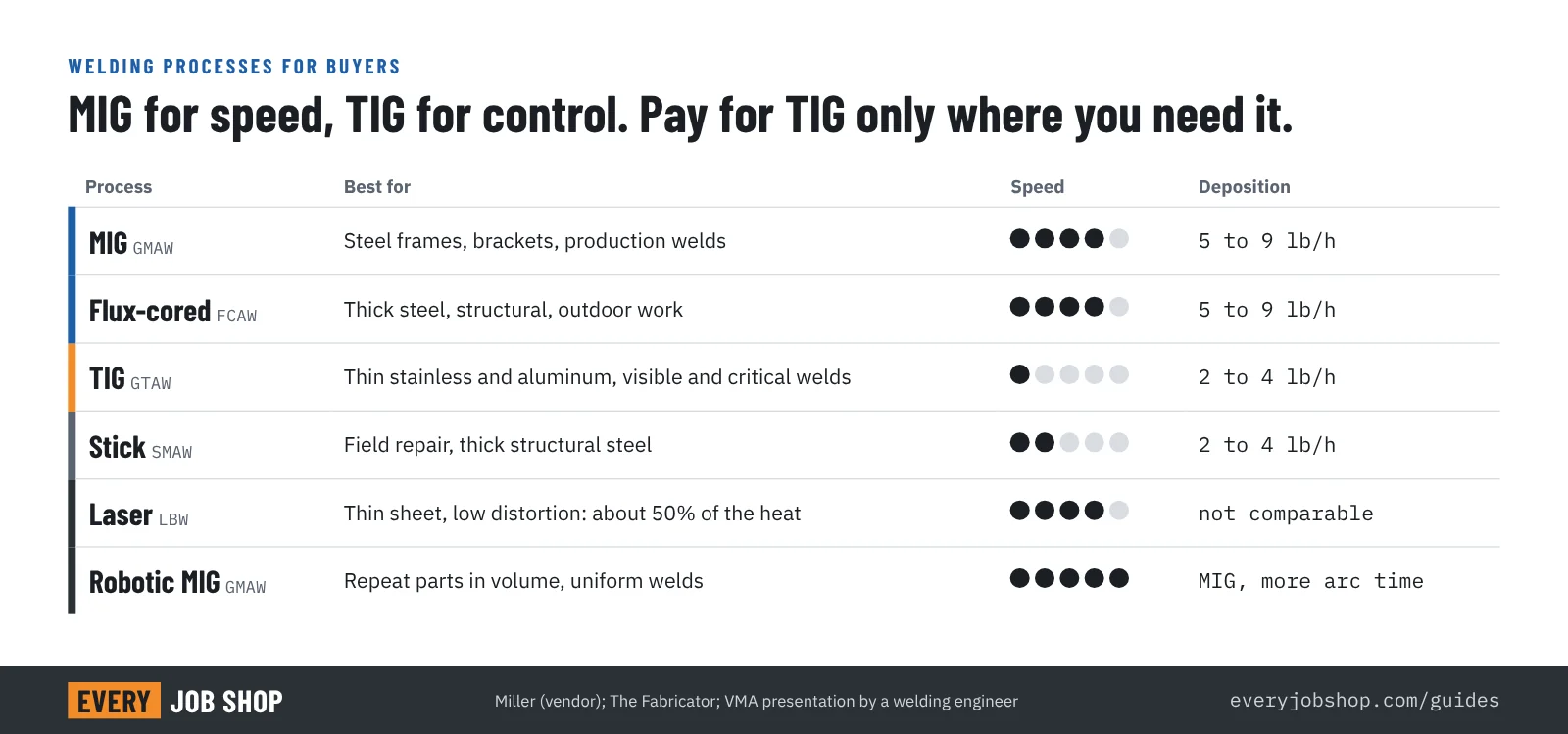

Comparison of welding processes for buyers: MIG (GMAW) fast, for steel frames and production welds; flux-cored (FCAW) fast, for thick and structural steel; TIG (GTAW) slowest, for thin stainless, aluminum and visible welds; stick (SMAW) slow, for field repair and thick steel; laser welding fast with about half the heat input; robotic MIG fast and consistent for repeat parts. Typical deposition: manual stick and TIG 2 to 4 lb per hour, semi-automatic MIG and flux-cored 5 to 9 lb per hour
Specify TIG where the joint or the look needs it and let the shop choose elsewhere. Deposition ranges include the time the welder is not welding.

The welding processes, in plain words

Process Also called Best for Speed Look and cleanup
MIG GMAW Steel frames, brackets, production welds in steel, stainless and aluminum Fast Some spatter, grinding where it shows
Flux-cored FCAW Thick steel, outdoor and structural work Fast Slag to remove
TIG GTAW Thin stainless and aluminum, visible welds, critical joints Slowest Clean, precise, heat tint to remove for a bright finish
Stick SMAW Field repair, thick structural steel Slow Slag to remove
Laser LBW Thin sheet, low distortion, high volume Fast Narrow seam, little heat tint
Robotic MIG Repeat parts in volume Fast and consistent Like MIG, more uniform

What the processes mean for your part:

The practical rule: specify TIG only where the joint or the appearance needs it, and let the shop choose MIG or a robot everywhere else.

Where the money in a weld goes

Filler wire and gas are a small share of a welded part. A Praxair specialist quoted in Trailer/Body Builders put 85% of welding costs in overhead and labor, with wire at 6%, equipment 4%, gas 3% and power 2% (2003, but the split follows from the arithmetic: the welder's time dominates).

So the price of a weldment follows the time it takes:

  • Weld length and size. The weld metal in a fillet weld grows with the square of its size.
  • Fit-up. Parts that are laser cut and tabbed into each other need little fixturing; parts cut on a saw and held with clamps take longer.
  • Position. Flat welds are fastest. Vertical and overhead welds are slower.
  • Distortion. Long welds on thin sheet pull the part out of shape, and straightening is extra work.
  • Cleanup and finish. Grinding welds flush, removing heat tint from stainless, and blending for paint can take longer than the welding.
  • Inspection. Visual inspection is part of every job; dye penetrant, magnetic particle, ultrasonic and radiographic testing are separate steps with their own cost.

Weld size: the line on the drawing that costs the most

A fillet weld one size larger than needed is the most common way to overpay. The cross-section of a fillet weld is half the leg squared, so a 3/8 in fillet holds 2.25 times the metal of a 1/4 in fillet, and a 1/2 in fillet four times.

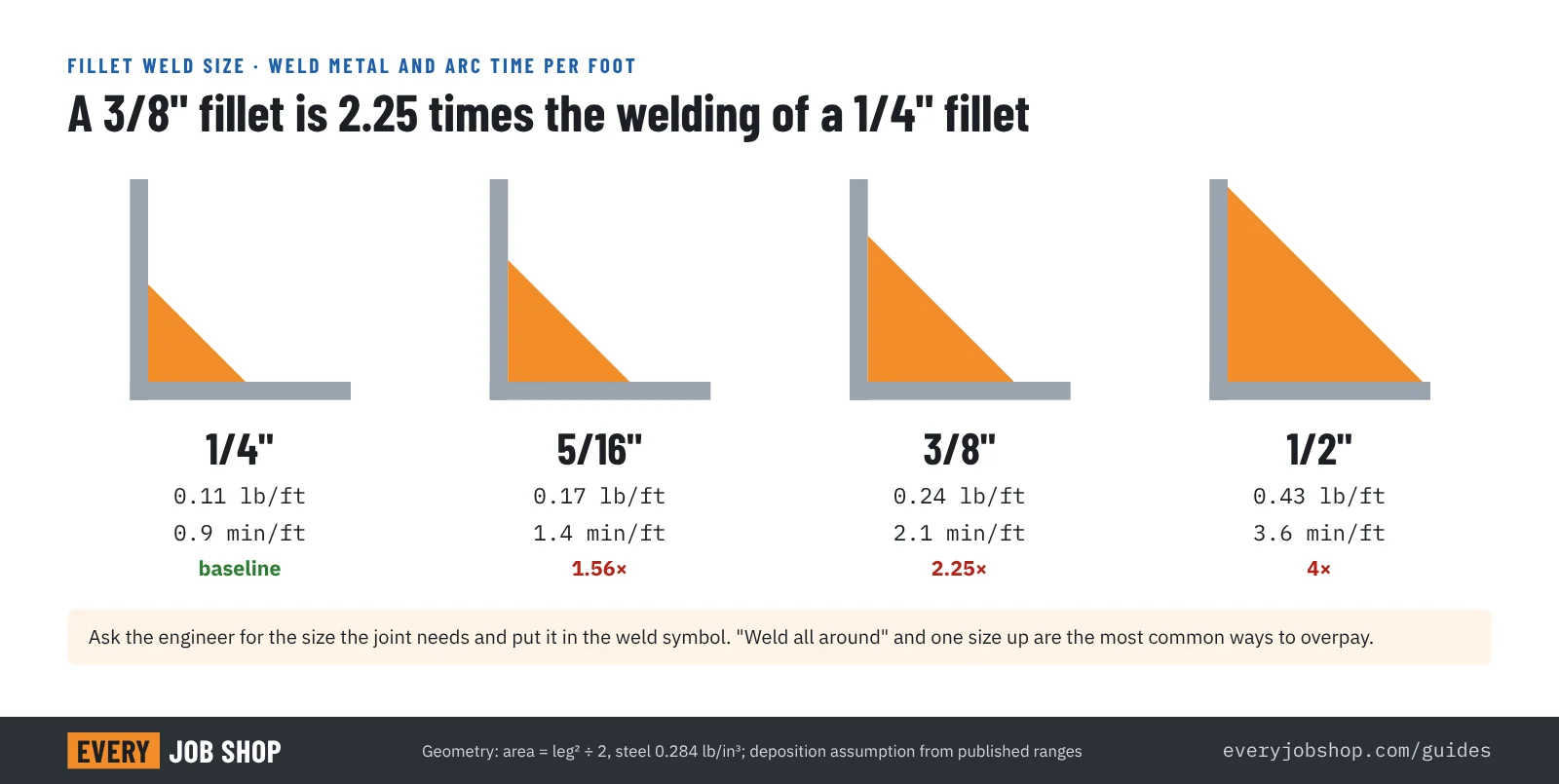

Chart of fillet weld size against weld metal and arc time per foot in steel: 1/4 inch 0.11 lb and 0.9 minutes, 5/16 inch 0.17 lb and 1.4 minutes, 3/8 inch 0.24 lb and 2.1 minutes, 1/2 inch 0.43 lb and 3.6 minutes at 7 lb per hour. A 3/8 inch fillet holds 2.25 times the metal of a 1/4 inch fillet
Weld metal grows with the square of the fillet size. Arc times assume semi-automatic MIG at 7 lb an hour; larger welds often need several passes and take longer.
Fillet size Weld metal per foot (steel) Relative Arc time per foot at 7 lb/h
1/4 in 0.11 lb 1.0 0.9 min
5/16 in 0.17 lb 1.6 1.4 min
3/8 in 0.24 lb 2.25 2.1 min
1/2 in 0.43 lb 4.0 3.6 min

Weld metal is the cross-section times 12 inches times the density of steel (0.284 lb per cubic inch). The arc times assume a semi-automatic MIG deposition of 7 lb an hour, in the middle of the range above; larger welds often need several passes and take longer. Ask your engineer for the size the joint needs, and write it on the drawing.

Which welding code applies

A welding code sets how procedures and welders are qualified, what is acceptable and how the work is inspected. The design or contract decides which one applies; if nothing does, say which code or shop standard you expect.

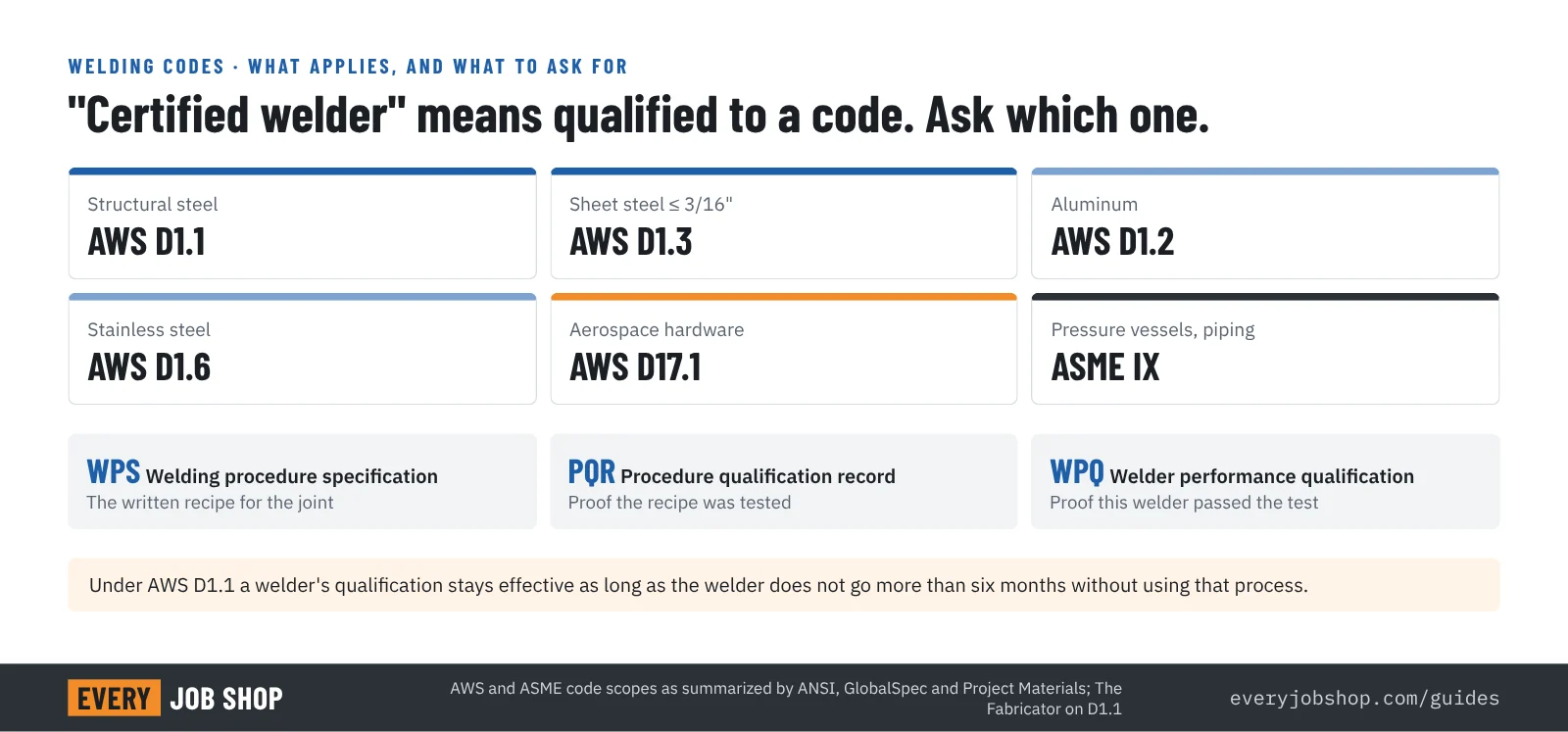

Guide to which welding code applies: structural steel AWS D1.1, structural sheet steel up to 3/16 inch AWS D1.3, aluminum AWS D1.2, stainless steel AWS D1.6, aerospace hardware AWS D17.1, pressure vessels and piping ASME Section IX with the construction code. Behind a coded weld: WPS, PQR and WPQ; under D1.1 a welder's qualification lapses after six months without using the process
The design or contract decides the code. Qualifications do not transfer automatically between codes; ask for the procedure and welder records for your joints.
Code Covers Typical parts
AWS D1.1 Structural welding of steel Frames, platforms, brackets, structural members
AWS D1.3 Structural sheet and strip steel up to 3/16 in nominal thickness Cold-formed and sheet steel structures
AWS D1.2 Structural welding of aluminum Aluminum frames and structures
AWS D1.6 Structural welding of stainless steel Stainless structures and supports
AWS D17.1 Fusion welding for aerospace applications Aircraft and space hardware
ASME Section IX Qualification of welding for pressure equipment, used with construction codes for boilers, vessels and piping Pressure vessels, process piping

Qualifications do not transfer automatically from one code to another: a welder qualified to ASME Section IX is not automatically qualified to AWS D1.1, and the reverse. If your part falls under a code, ask the shop whether its procedures and welders are qualified to that code, not just "certified".

What "certified welder" means, and what to ask for

Three documents sit behind a coded weld:

  • WPS, the welding procedure specification: the written recipe for a joint, with process, filler metal, gas, current, positions and thickness range.
  • PQR, the procedure qualification record: proof that the recipe was tested and the test welds passed.
  • WPQ, the welder performance qualification: proof that a named welder passed a test weld to that procedure.

Under AWS D1.1, a welder's qualification stays effective as long as the welder does not go more than six months without using that process. That is why shops keep continuity logs. When a buyer asks for "certified welders", the useful request is: the WPS for your joints and the current WPQs of the welders who will weld them.

A CWI, an AWS Certified Welding Inspector, is the person who checks the work. Candidates pass three exams (fundamentals, practical and code book) with at least 72% on each; the certification is valid for nine years with renewals at years three and six. Ask whether the shop has a CWI on staff or uses an outside inspector, and who signs the inspection report.

What to put on the drawing

  • Weld symbols to the AWS A2.4 standard, with the type, size, length and pitch of each weld. "Weld all around" on every joint is an invitation to overpay.
  • The process only where it matters, for example TIG on a visible stainless seam.
  • The code and the acceptance criteria, if the part falls under one.
  • Inspection: visual only, or which welds need dye penetrant, magnetic particle, ultrasonic or radiographic testing, and how many.
  • Finish: as welded, ground flush, blended for paint, heat tint removed or passivated.
  • Critical dimensions after welding, so the shop knows what must stay flat or square.

Our DFM guide covers the design side: tab-and-slot parts, access for the torch and welds that pull parts out of tolerance.

Six ways to cut the cost of welded parts

  1. Specify the weld size the joint needs, not one size up.
  2. Use intermittent welds where a continuous weld is not structural.
  3. Let the shop choose MIG where the appearance does not matter.
  4. Design laser cut parts that locate themselves with tabs and slots, so fixturing takes minutes.
  5. Ask for grinding only on visible or mating surfaces.
  6. Combine cutting, bending, welding and finishing at one shop. Our laser cutting cost guide shows how fixed costs per order add up across separate suppliers.

Find welding shops

EveryJobShop lists 2,111 US shops that offer welding: 1,038 list aluminum, 918 stainless steel and 331 hold AS9100. The most are in California (274), Texas (134), Ohio (127), Pennsylvania (123) and Michigan (116). Filter by material and certification in the full list, use our 12 questions for a new shop, and send one RFQ to up to 30 shops at once.

Questions people ask

Is MIG or TIG welding better?
Neither is better in general. MIG (GMAW) is faster and puts less total heat into the part, so it is the usual choice for steel fabrications and production work. TIG (GTAW) is slower and needs a more skilled welder, but gives precise control and a clean look on thin stainless, aluminum and visible welds. Specify TIG only where the joint or the appearance needs it.
What does a welded part cost?
Mostly time. A Praxair specialist put 85% of welding cost in labor and overhead, with wire at 6%, equipment 4%, gas 3% and power 2%. The price follows the length and size of the welds, the process, the position, the fit-up and the cleanup and inspection the drawing asks for.
What does a certified welder mean?
Under codes such as AWS D1.1, a welder is qualified by passing a test weld to a written procedure, and the qualification covers a process, position and range of thicknesses. Under D1.1 it stays valid as long as the welder does not go more than six months without using that process. Ask the shop for the welder qualification records and the welding procedure that apply to your part.
Which welding code applies to my part?
The design or contract decides. Structural steel is usually AWS D1.1, structural sheet steel up to 3/16 inch AWS D1.3, aluminum AWS D1.2, stainless AWS D1.6, aerospace hardware AWS D17.1, and pressure vessels and piping ASME Section IX with the construction code. If none applies, say which code the shop should work to, or which shop standard is acceptable.
What is a CWI?
An AWS Certified Welding Inspector. Candidates must pass three exams (fundamentals, a practical exam and a code book exam) with at least 72% on each. The certification is valid for nine years, with renewal applications at years three and six.
